How bags are manufactured

The steps a handbag or backpack goes through in an OEM factory, from your first brief to cartons leaving the warehouse, and what you need to decide at each one.

By Connect5 Bags · Updated · 3 min read

On this page
  1. The process at a glance
  2. How long it usually takes
  3. What you decide, and when
  4. What drives the cost of a bag
  5. Working with Connect5
  6. Questions buyers ask

The process at a glance

  1. Brief and tech pack. You describe the bag: sketches or a reference sample, dimensions, materials, colours, branding, target price and quantity. A tech pack puts it in one document.
  2. Costing and material proposal. The factory proposes materials and hardware that meet the brief and the target price, sends swatches and gives an indicative quote.
  3. Pattern making. A pattern maker converts the approved sketches to flat paper or digital patterns for every panel, pocket and lining piece.
  4. Prototype (first sample). The sample room cuts and sews the first bag, usually with available materials in a close colour.
  5. Revisions. You comment on shape, size, details and function; the pattern is corrected and a new sample is made. Two or three rounds are normal for a new design.
  6. Salesman or photo samples (optional). Small runs in the correct colours for selling, catalogues or photography.
  7. Pre-production (PP) sample. Made with bulk materials and the production method. Your approval fixes the specification for the order.
  8. Bulk materials. Fabrics, leather, zips, hardware, labels and packaging are ordered, received and inspected against the approved swatches.
  9. Cutting. Panels are cut with steel dies, CNC or laser cutters, or by hand for leather, keeping grain and pattern direction consistent.
  10. Preparation and branding. Printing, embroidery, embossing or patches are applied to flat panels; leather is skived (thinned at the edges) and edges prepared.

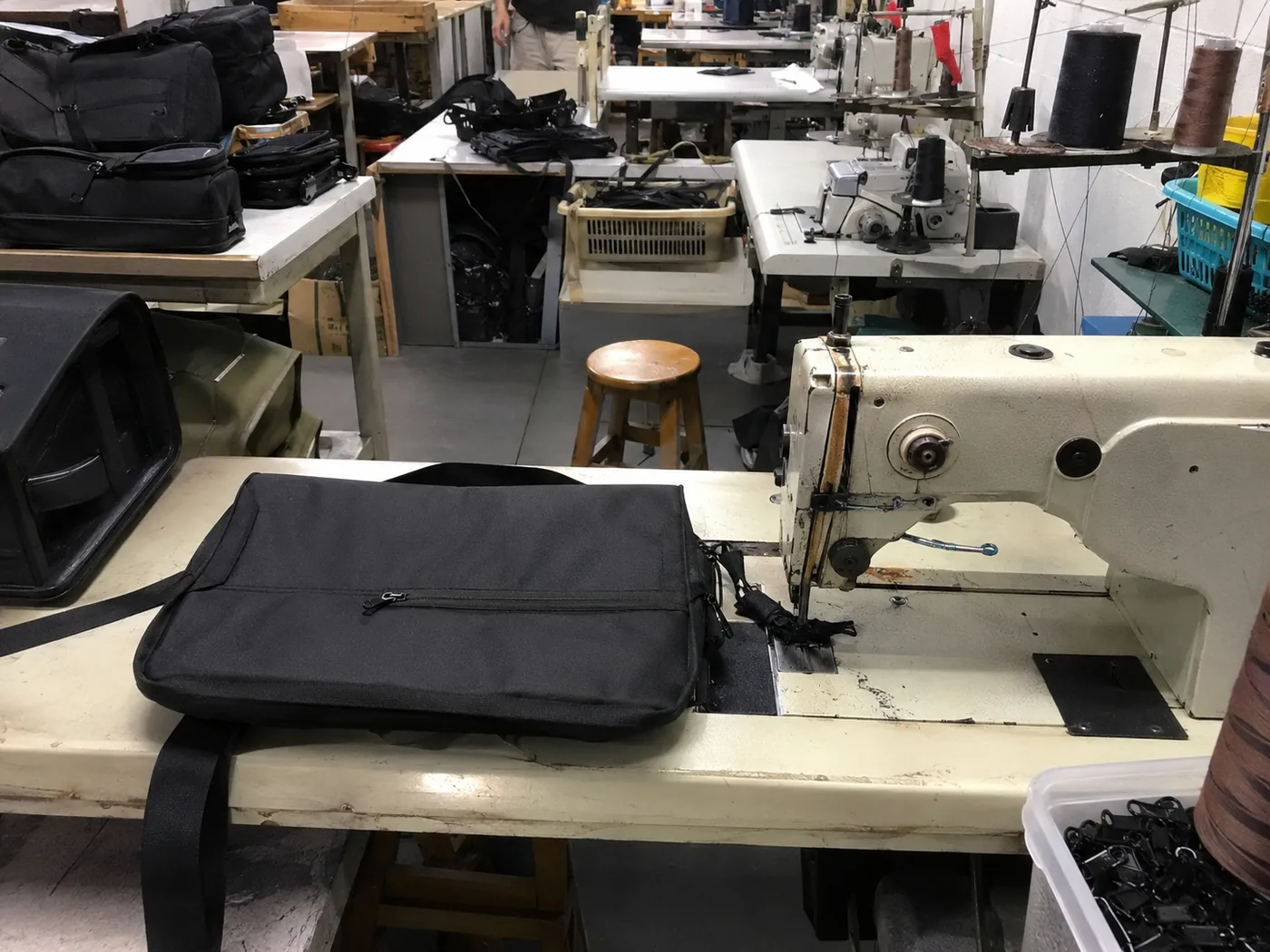

  11. Sewing and assembly. The production line builds pockets and sub-assemblies first, then joins the body, lining, straps and hardware.
  12. Finishing. Threads are trimmed, leather edges painted, bags shaped with stuffing and cleaned.
  13. Inspection. In-line checks during sewing and a final random inspection on finished cartons, using the quality control checklist.
  14. Packing and shipment. Hangtags, polybags, barcodes and carton marks; then loading for sea, air or rail freight.

How long it usually takes

Typical industry timings for a new bag design (not a Connect5 quotation)
StageTypical timeWhat decides it
Each sample round1–3 weeksDesign complexity, whether materials are in stock, courier time
Bulk materials2–5 weeksCustom colours, printed fabrics, custom hardware and branded zips
Bulk production3–8 weeks after PP approvalOrder quantity, number of colours, line capacity in the season
Shippingdays (air) to weeks (sea)Freight mode and destination

The biggest delays are usually late approvals and changes after the PP sample. Agreeing the full specification before the PP sample saves more time than anything else. Back-to-school ranges need the most planning, because retailers set their delivery windows months ahead of the season.

What you decide, and when

  • Before costing: target retail or landed price, quantity per style and per colour, the markets you sell in.
  • Before the first sample: dimensions, main materials, number of pockets, logo method.
  • Before the PP sample: final colours (lab dips approved), hardware finish, labels and packaging, test requirements.
  • Before shipment: inspection standard (AQL), carton marks, shipping terms.

What drives the cost of a bag

Roughly in order of impact: the main material (genuine leather costs far more than polyester or PU), the number of panels, pockets and operations (every extra seam is labour), hardware and custom trims, branding methods, the order quantity per colour (set-up costs are shared over fewer pieces on small runs), and packaging. When a quote is over target, simplifying construction usually saves more than changing fabric.

Working with Connect5

Connect5 runs this process in two factories: Guangdong, China and Phnom Penh, Cambodia, with sample rooms, cutting tables and sewing lines (photos on our About page). Pick a style from the collections as a starting point or send your own design, and email your brief to begin with costing and a first sample.

Questions buyers ask

How many samples does a new bag design need?

Usually two or three rounds of samples before the pre-production sample. Simple designs adapted from an existing style can need only one.

What is the difference between a prototype and a PP sample?

A prototype checks the design and fit, often with substitute materials. A pre-production (PP) sample is made with the bulk materials and methods and, once approved, is the standard for the order.

How long does bag production take?

For a new design, sampling often takes four to eight weeks in total, and bulk production three to eight weeks after the PP sample is approved, depending on quantity and materials. Lead times are always confirmed per order.

What is skiving in bag making?

Thinning the edges of leather panels so that folded edges and seams are not bulky. It is done on a skiving machine before the edges are folded, painted or stitched.
